[SMM Analysis] India Solar PV Market Annual Review 2025 and 2026 Outlook: Balancing Localization with Aggressive Growth Targets

Published: Jan 13, 2026 16:18
Source: SMM
Following the cancellation of China’s export tax rebates for photovoltaic products, the global solar trade landscape is undergoing significant restructuring. India, underpinned by massive domestic demand and unwavering policy commitment, is rapidly emerging as one of the most strategic markets outside of China. As a high-growth region with global competitiveness, India accelerated its energy transition throughout 2025, demonstrating remarkable market resilience. By November 2025, India’s cumulative PV installed capacity surpassed 130 GW. Notably, the market added approximately 35 GW in 2025 alone, positioning the country as a core driver of renewable energy expansion both regionally and globally.

Following the cancellation of China's export tax rebates for photovoltaic products, the global solar trade landscape is undergoing significant restructuring. India, underpinned by massive domestic demand and unwavering policy commitment, is rapidly emerging as one of the most strategic markets outside of China. As a high-growth region with global competitiveness, India accelerated its energy transition throughout 2025, demonstrating remarkable market resilience. By November 2025, India's cumulative PV installed capacity surpassed 130 GW. Notably, the market added approximately 35 GW in 2025 alone, positioning the country as a core driver of renewable energy expansion both regionally and globally.

This analysis reviews the Indian PV sector's performance in 2025 and provides an outlook for 2026 within the new global trade context.

Installed Capacity and Market Structure

Official statistics indicate that India's cumulative PV installed capacity has reached 132.85 GW. Utility-scale projects constitute the backbone of the market, accounting for 75.8% of the total capacity (approximately 100.8 GW). The remaining capacity is distributed among rooftop solar (23.16 GW), off-grid systems (5.55 GW), and hybrid projects (3.34 GW).

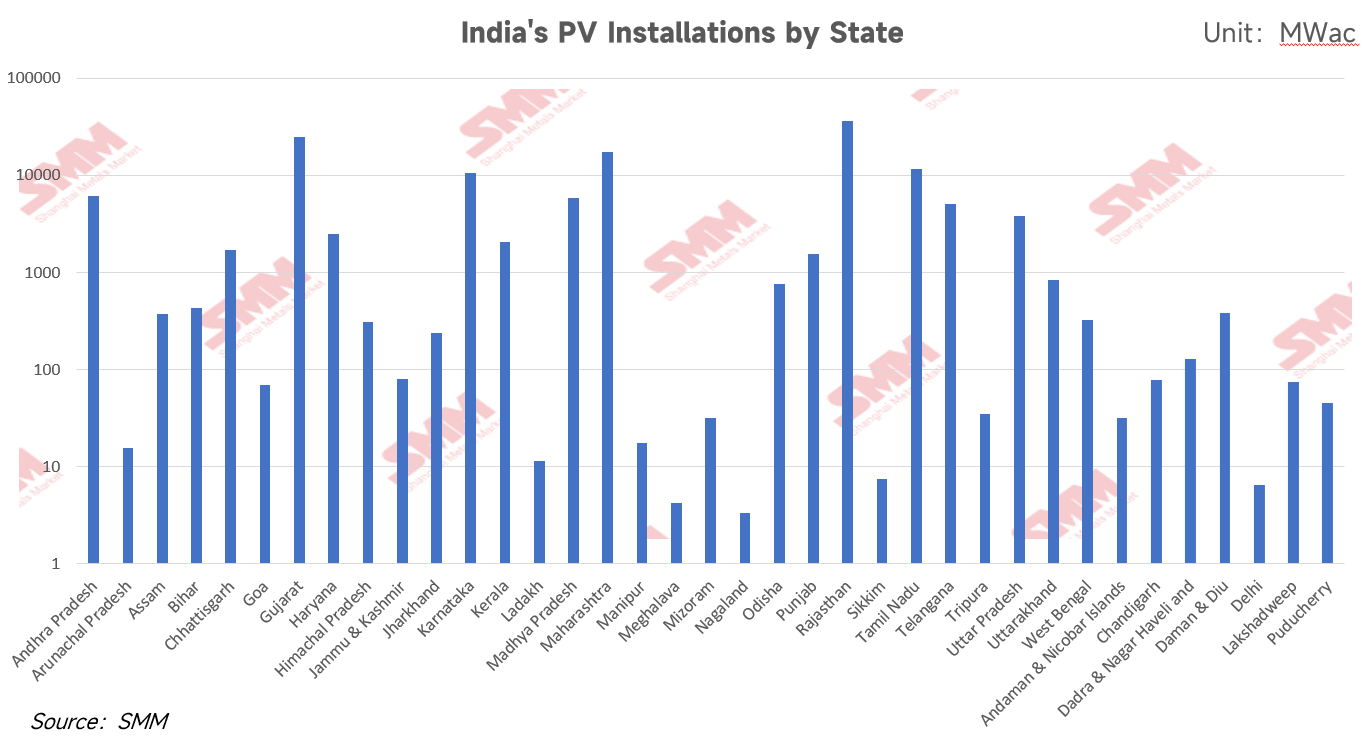

Regionally, industrial clustering is pronounced due to variations in resource endowment and policy direction. Rajasthan, Gujarat, and Maharashtra have established themselves as the leading hubs, collectively accounting for approximately 60% of the national total. Their respective installed capacities stand at 35.91 GW, 24.79 GW, and 17.17 GW.

Manufacturing Capabilities and Supply Chain Dynamics

While India significantly expanded its PV manufacturing capacity in 2025, the supply-demand structure across the value chain remains unbalanced. Module production capacity has exceeded 170 GW, sufficient to meet the majority of domestic demand. However, cell production capacity lags significantly at approximately 29 GW. Furthermore, domestic manufacturing capabilities for polysilicon and wafers remain insufficient to support module manufacturers, resulting in a high dependency on imported raw materials. This lack of vertical integration exposes the supply chain to risks regarding critical mineral export controls and international price volatility.

Price Bifurcation and Trade Policy Environment

Influenced by trade barriers and localization policies, the Indian PV market in 2025 exhibited distinct price bifurcation, with policy uncertainty challenging project economics. According to SMM research, module prices vary drastically based on supply origin. Non-DCR (Domestic Content Requirement) modules maintained a low price range of $0.14–0.15/W. Conversely, due to the scarcity of upstream cell capacity and higher manufacturing costs, DCR modules remained expensive, trading in the $0.27–0.30/W range, showing a price differential of nearly 100%.

As new large-scale government projects are mandated to use modules listed in the Approved List of Models and Manufacturers (ALMM), SMM forecasts that prices for India-made non-DCR modules will likely decrease further. However, if the government moves to completely exclude the Chinese supply chain and enforce strict DCR compliance, solar plant construction costs will rise sharply, potentially eroding the levelized cost of energy (LCOE) advantage of Indian solar power.

Trade Remedy Investigations and Legal Disputes

To address supply chain dependencies, the Directorate General of Trade Remedies (DGTR) under India's Ministry of Commerce previously recommended an anti-dumping duty of up to 30% on Chinese imports. In response, the Rajasthan Solar Association (RSA) filed a legal challenge. The Supreme Court of India subsequently issued an interim order ruling that, pending a final verdict, any tax notification based on this recommendation remains invalid and unenforceable.

While this judicial intervention temporarily preserves access to lower-cost products for developers, the industry remains concerned. The potential future implementation of protectionist tariffs, superimposed on existing Basic Customs Duties (BCD), would increase energy transition costs and potentially delay the achievement of the 2030 targets.

Trends in Project Tendering

In 2025, tender activity evolved toward technologically complex, composite projects:

  • Shift in Tender Typology The proportion of standalone solar tenders has declined. The majority of grid-scale tenders now incorporate energy storage systems (ESS) or adopt wind-solar hybrid models to enhance peak-shaving capabilities. Project configurations are accelerating toward highly integrated models such as Round-the-Clock (RTC) and Firm and Dispatchable Renewable Energy (FDRE). Despite increased complexity, winning bid tariffs have maintained a downward trend, driven by significant reductions in storage costs and the optimization of multi-energy complementary solutions. This indicates that leading Indian enterprises have successfully navigated the initial learning curve regarding cost control and technical integration for complex energy systems.
  • Tightening of Energy Storage Localization The Ministry of Power has stipulated that energy storage projects funded through Viability Gap Funding (VGF) must satisfy a local content requirement of at least 20%. Additionally, the Ministry rejected waiver applications from several states regarding the "Public Procurement (Preference to Make in India)" (PPP-MII) order, establishing a unified enforcement threshold. While aimed at forcing supply chain localization, the limited availability of compliant supply sources may inflate tender costs in the short term.

Structural Obstacles to Industry Development

Despite the growth in installed capacity, the Indian solar sector faces four major structural constraints at the execution level:

  • Delays in Power Purchase Agreements (PPA): As of September 2025, Power Sale Agreements (PSA) for approximately 44 GW of awarded projects remain unsigned. Fluctuating demand from Distribution Companies (Discoms) and delays in grid construction have extended the cycle from bid award to financial closure.

  • Grid Absorption and Transmission Constraints: High-growth regions like Rajasthan and Gujarat are experiencing delays in the construction of the Inter-State Transmission System (ISTS) relative to generation capacity. This misalignment has resulted in curtailment rates ranging from 10% to 30% in these areas.

  • Supply Chain Uncertainty: The scarcity of upstream raw material manufacturing capability leaves the Indian PV industry vulnerable to external supply fluctuations. Export control policies from major raw material exporting nations pose a direct threat to supply chain stability.

  • Regulatory Volatility: Regulatory instability remains a risk. For instance, certain state-level regulators (e.g., in Maharashtra) adjusted banking and wheeling charge policies in July 2025 (subsequently stayed by the High Court). Such frequent changes increase financial modeling risks for Commercial & Industrial (C&I) and Open Access projects.

2026 Market Outlook

Based on a neutral expectation regarding the implementation of ALMM List 2, SMM forecasts that new PV installations in India will reach approximately 45 GW in 2026. This represents a year-on-year growth rate of 24%, a significant deceleration compared to the robust 41% growth observed in 2025.

The core constraint driving this slowdown is the ALMM List 2 regime, scheduled for mandatory enforcement in June 2026. If domestic cell production capacity cannot effectively meet downstream demand in terms of cost-performance and technical specifications, supply chain bottlenecks will ensue, leading to project delays and suppressed growth.

Facing the rigid assessment of the 2030 target (500 GW of renewable energy), the Indian government must navigate the delicate balance between protecting domestic manufacturing and achieving installation targets. SMM assesses that to prevent supply shortages from dragging down overall progress, the government is highly likely to introduce pragmatic amendments to ALMM List 2, effectively moderating the mandatory requirements for domestic cells. Concurrently, the shift of procurement focus toward Southeast Asia is expected to accelerate to bridge the supply-demand gap during this transition and mitigate geopolitical tariff risks.

On the pricing front, as leading Indian enterprises accelerate their upstream expansion into wafers and other components, improved vertical integration will drive cost reductions. Consequently, the price differential between domestic DCR modules and non-DCR modules is expected to narrow gradually.

Looking ahead, while the growth potential of the Indian PV market is undeniable, the continuity and flexibility of the policy environment, specifically the ability to timely remove supply-side obstacles will be decisive. Furthermore, improvements in supporting infrastructure, particularly grid access capabilities and the contract compliance rates of PPAs, are indispensable cornerstones for realizing India's ambitious 500 GW vision.

Written by: Ryan Tey

Data Source Statement: Except for publicly available information, all other data are processed by SMM based on publicly available information, market communication, and relying on SMM‘s internal database model. They are for reference only and do not constitute decision-making recommendations.

For any inquiries or to learn more information, please contact: lemonzhao@smm.cn
For more information on how to access our research reports, please contact:service.en@smm.cn
Related News
[SMM PV News] EU Proposes 'Industrial Accelerator Act' Mandating Local Content for Solar and BESS
Mar 6, 2026 11:15
[SMM PV News] EU Proposes 'Industrial Accelerator Act' Mandating Local Content for Solar and BESS
Read More
[SMM PV News] EU Proposes 'Industrial Accelerator Act' Mandating Local Content for Solar and BESS
[SMM PV News] EU Proposes 'Industrial Accelerator Act' Mandating Local Content for Solar and BESS
The European Commission's newly drafted Industrial Acceleration Act (IAA) requires publicly subsidized clean energy projects to use EU-manufactured components. Photovoltaic projects must integrate EU-made inverters and solar cells within 3 years, a transition period praised by some for balancing reshoring but criticized by others as too slow to counter Chinese competition. Besides, BESS over 1 MWh face an aggressive timeline requiring EU-made battery management systems within 1 year and EU cells within three, which industry experts warn could stall storage rollouts. Additionally, the Act enforces strict barriers on strategic investments over €100 million from nations that 'control more than 40% of global capacity,' mandating technology transfers and capping foreign equity ownership at 49%.
Mar 6, 2026 11:15
[SMM PV News] Brazil's 439 MW Bom Jardim Solar Complex Begins Testing
Mar 6, 2026 11:14
[SMM PV News] Brazil's 439 MW Bom Jardim Solar Complex Begins Testing
Read More
[SMM PV News] Brazil's 439 MW Bom Jardim Solar Complex Begins Testing
[SMM PV News] Brazil's 439 MW Bom Jardim Solar Complex Begins Testing
Brazil's 439 MW Bom Jardim solar complex in Ceará has begun testing four of its 10 plants. Backed by a BRL 2.13 billion ($407 million) investment and qualifying for REIDI tax incentives, the 706-unit project targets full commercial operation by December 2027. Generated power will be routed via an 8 km transmission line to the 230 kV Icó Substation, with the development expected to create over 20,000 direct and indirect jobs.
Mar 6, 2026 11:14
[SMM PV News] Japan Adds Up to 6 GW Solar in 2025
Mar 6, 2026 11:14
[SMM PV News] Japan Adds Up to 6 GW Solar in 2025
Read More
[SMM PV News] Japan Adds Up to 6 GW Solar in 2025
[SMM PV News] Japan Adds Up to 6 GW Solar in 2025
Japan installed an estimated 5.8 to 6 GW of solar in 2025, pushing its cumulative capacity past 100 GW. According to RTS Corp, growth was driven by C&I power purchase agreements and new-build rooftop solar mandates in Tokyo and Kawasaki. Installations in 2026 are expected to remain steady, with a potential market rush before FiT/FiP subsidies for >10 kW systems end in FY2027. Long-term, Japan aims for solar to be its largest power source by 2040 (targeting up to 280 GW) and is actively subsidizing perovskite technology to hit a 20 GW target.
Mar 6, 2026 11:14
[SMM Analysis] India Solar PV Market Annual Review 2025 and 2026 Outlook: Balancing Localization with Aggressive Growth Targets - Shanghai Metals Market (SMM)
